Asphalt shingle roof deck on a Southwest Florida house

Information

Sealed roof deck and secondary water barrier.

After Hurricane Ian, the covering leaving is not the only failure. Water through the deck is. This page is about what actually seals the wood — and what the insurance form will accept. It is a guide, not a product page.

Information

The deck is the last line if the shingles leave.

A sealed roof deck is a water barrier on the wood itself. Secondary water resistance (SWR) is the insurance term on Florida form OIR-B1-1802. They overlap. They are not the same as “we put underlayment on it.”

Peel-and-stickTaped jointsFelt is not SWRWBDR, not HVHZ

1. Why this page exists after Ian

In a hurricane, shingles and tiles come off. What happens next is whether rain has a clear path into the attic through every plywood joint. Houses that kept a bonded layer on the deck often lost covering and still kept the interior. Houses that had only felt or a loose synthetic sheet often took water as soon as the nails pulled.

That is the point of a sealed deck: the covering is the primary roof. The layer on the wood is what you have left when the primary roof is gone.

2. Three assemblies people confuse

Full-deck peel-and-stick

Self-adhering polymer-modified bitumen (ASTM D1970) bonded to the entire sheathing. Best water barrier if the covering leaves. Has to go on clean, dry wood — not on top of felt if you want the insurance credit.

Taped joints + underlayment

Four-inch self-adhering tape on every sheathing joint, then a synthetic or self-adhered sheet over the field. Seals the cracks the rain finds first. The tape is the SWR path; the sheet is still underlayment.

Double felt

Two layers of asphalt-saturated felt. Common, cheap, and still used to meet some code minimums. It is not a sealed deck. It is not SWR on the wind-mitigation form.

Sloped Florida roof fully covered in self-adhered membrane
Full-deck self-adhered membrane on a sloped roof. This is the assembly the insurance form usually means by SWR.

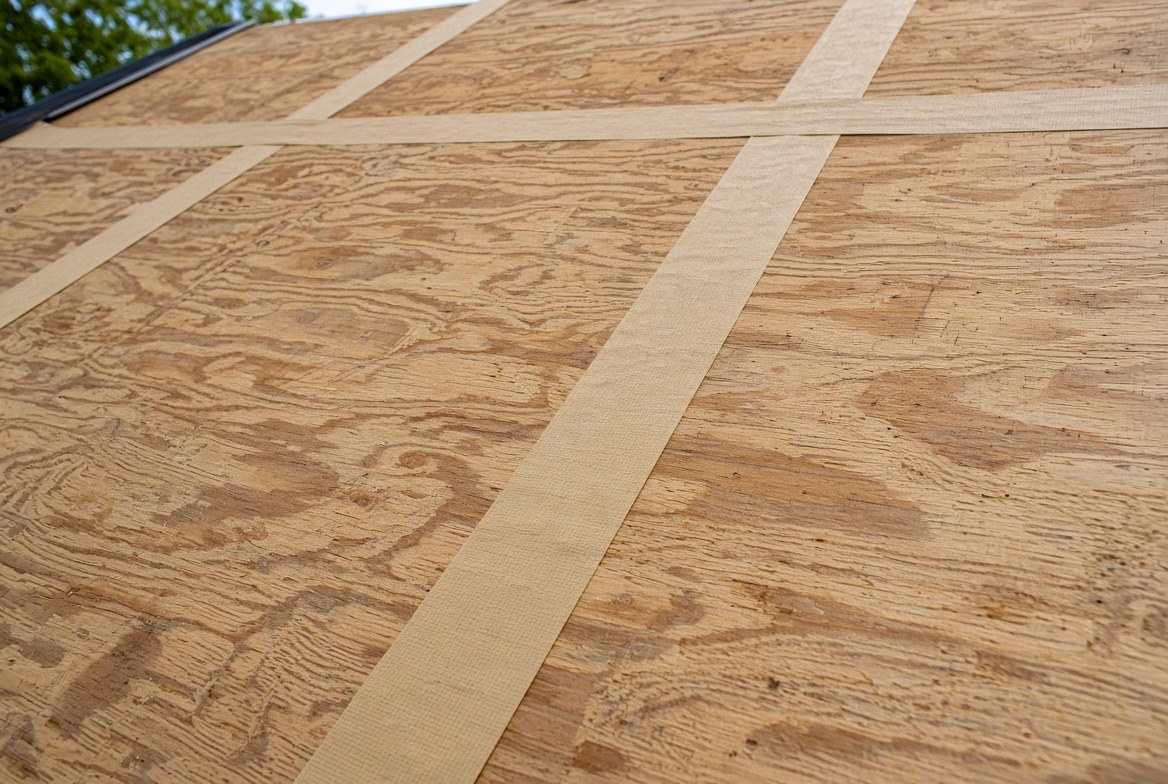

Plywood roof sheathing joints covered with wide seam tape
Taped joints seal the cracks rain finds first. The field still needs an underlayment sheet on top.

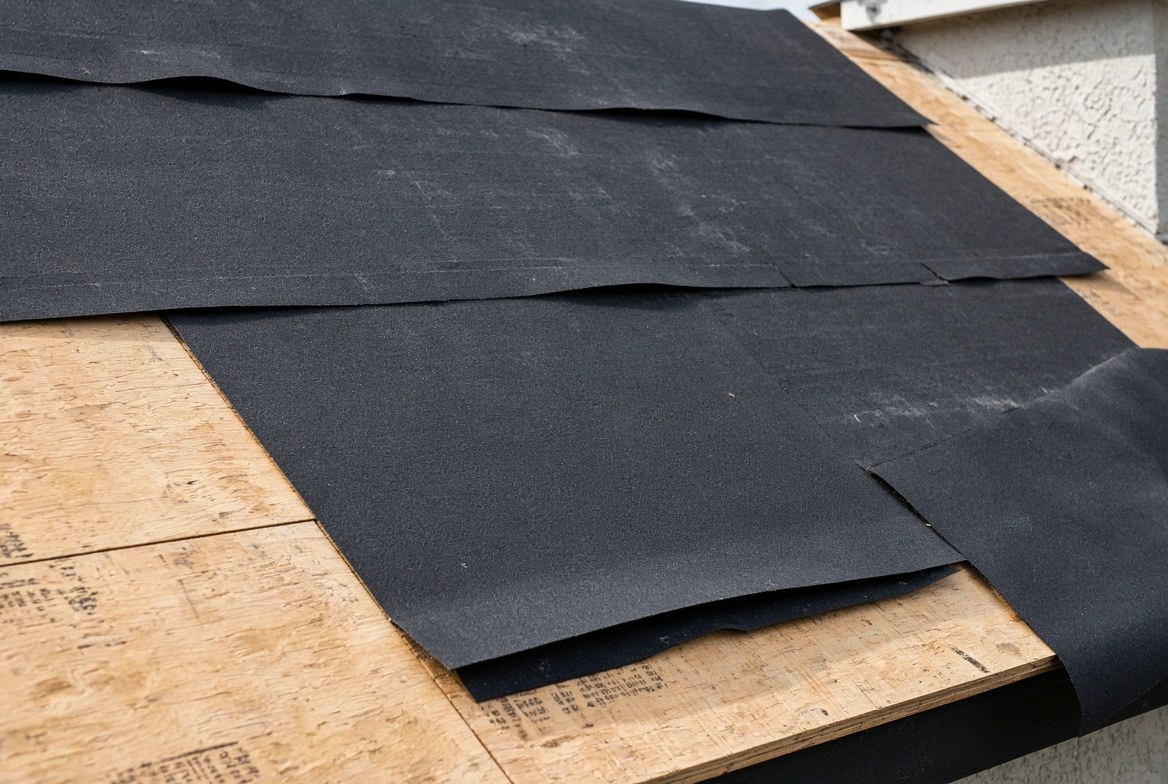

Asphalt felt underlayment laid over a plywood roof deck
Felt can meet a code minimum. It is not a sealed deck and it is not SWR on OIR-B1-1802.

3. What the wind-mitigation form counts as SWR

Form OIR-B1-1802 is narrow. Standard underlayments and hot-mopped felts are called out as not SWR. The two paths that inspectors will usually mark “SWR” are:

  • Self-adhering polymer-modified bitumen applied directly to the sheathing — full-deck peel-and-stick, or qualifying tape on the joints.
  • A foam SWR barrier applied as a secondary means to keep water out. That is not the same product as spray-foam attic insulation.

Peel-and-stick laid on top of felt is often a fine roof. It is a poor SWR credit. The form wants the membrane bonded to the wood. If you pull the sheet and felt comes with it, the inspector is looking at paper on a table, not tape on the deck.

4. What does not count

  • Single or double #15 / #30 felt
  • Synthetic underlayment alone, even a heavy one
  • Peel-and-stick only at eaves and valleys
  • Peel-and-stick over felt instead of on the wood
  • A Miami-Dade “hot mop” that the building code may call a water barrier but the OIR form does not treat as SWR

Building code and the insurance form use the same words for different things. Passing inspection at the city does not automatically mark SWR on OIR-B1-1802.

5. Wind-Borne Debris Region is not HVHZ

Those labels get used as if they were the same rulebook. They are not.

High-Velocity Hurricane Zone (HVHZ)

A named zone in the Florida Building Code: Miami-Dade and Broward only. It brings its own roof chapter — product approvals, tests, and underlayment rules written for that zone. A “Miami-Dade NOA” or “HVHZ spec” is that chapter, not a nickname for any windy county.

Wind-Borne Debris Region (WBDR)

A wind-speed map, not a county name. Where design wind is high enough that flying debris is assumed, glazed openings need impact protection or shutters. Cape Coral, Fort Myers, and the rest of Southwest Florida sit in this region. Roofs still have to be built for wind. They do not automatically fall under the HVHZ roof chapter.

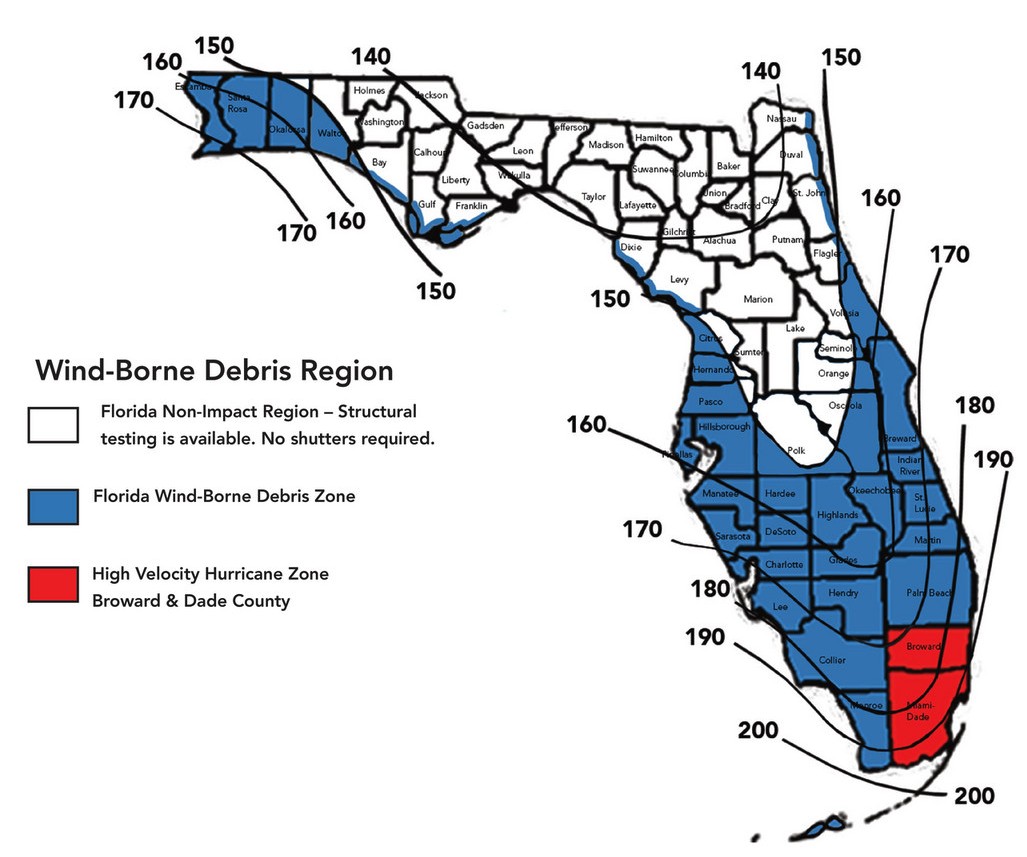

Florida map showing Wind-Borne Debris Region in blue and High-Velocity Hurricane Zone in red for Broward and Miami-Dade
Blue is Wind-Borne Debris Region. Red is HVHZ — Broward and Miami-Dade only. Lee, Collier, Charlotte, and Sarasota are blue, not red.

Practical difference on a bid: WBDR decides whether the windows and garage door have to stop debris. HVHZ decides a separate Miami–Broward roof rule set. Using HVHZ language on a Southwest Florida permit does not make the house safer by itself, and it does not mark SWR on the insurance form.

Quotes that sell “HVHZ spec” on a Cape Coral or Fort Myers house are either confused or selling a Miami product on a local permit. Ask which code path the permit actually uses. Then ask separately whether the underlayment is SWR on the insurance form. Those are two checklists.

Say it plainly.Cape Coral, Fort Myers, and the rest of Southwest Florida are Wind-Borne Debris Region. They are not HVHZ. Do not let a bid treat them as the same place.

6. A cheaper underlayment can pass code and fail the house

Code sets a floor: keep water out while the covering is in place. Ian showed what happens when the covering is gone and the floor was only felt. The house can be legal the morning of the storm and open to the attic by afternoon.

If the goal is “the wood stays dry after the shingles leave,” budget for full-deck self-adhered or taped joints plus a sheet that belongs on that covering. If the goal is “cheapest permit,” felt will often get the stamp. Those goals are not the same bid.

7. Questions to ask before the deck is covered

  • Is the self-adhered membrane going on the wood, or on felt?
  • Full deck, or eaves and valleys only?
  • If you are taping joints, what tape, what width, and will I get photos of every run?
  • Will this mark SWR on OIR-B1-1802, or only meet the permit?
  • Are you bidding Southwest Florida WBDR or quoting Miami HVHZ language?

Educational summary. Not a specification or a promise that any carrier will credit SWR. The inspector and the form in force on inspection day control the checkbox.
